Skip to main content

Featured Post

Atlantic Yards/Pacific Park FAQ, timeline, and infographics (pinned post)

Atlantic Yards/Pacific Park FAQ, timeline, and infographics (pinned post)

The information in the text has been updated through Dec. 17, 2024, though considerable uncertainty remains: note buildings with question marks, as well as the project's general history of changes.

From The Real Deal
For a concise history of the project, see my May 8, 2024 article, Watch This Space, published by Urban Omnibus. Also see my Substack post, Getting Up to Speed on Atlantic Yards, which collects numerous relevant articles. For what might be next, see To Rescue Atlantic Yards, Developer Sought to Supersize Project.

Subscribe to my weekly Substack newsletter, Learning from Atlantic Yards/Pacific Park, which includes new essays and a weekly roundup of this blog. Follow me on TwitterContact info here. Information on my Atlantic Yards tours is here.

Atlantic Yards/Pacific Park is complicated, and it's changed a lot. Eight of 15 (or 16) towers have been completed, plus the Barclays Center arena. The latest two towers were completed only in 2023, and the surrounding open space--for a total of 3 acres (out of a planned 8 acres)--was finished only then.

But the project is, essentially, stalled--and, as of now, in deep peril, given and oft-postponed foreclosure sale of the six railyard development sites (B5-B10), which likely will lead to a new joint-venture involving Related Companies, developer of Hudson Yards.

(It's unclear what changes might be approved, given potential state-imposed obligations and likely renegotiations, but yes, it is "Crunch time," as The Real Deal put it. See the second graphic, below, for 2023 proposals to supersize the project.)

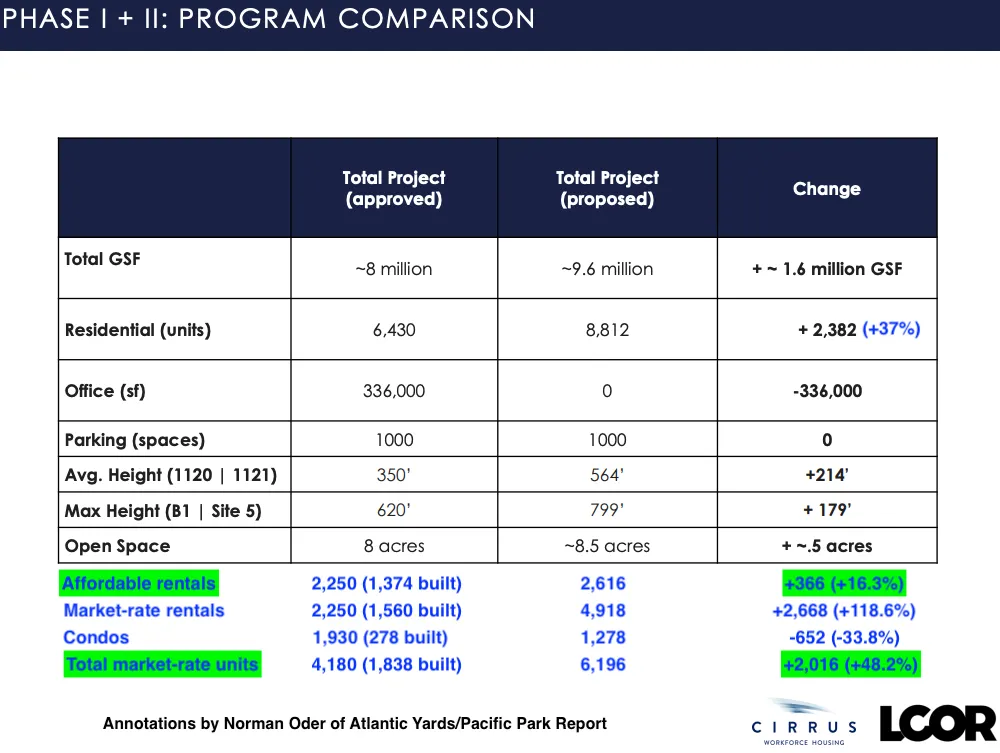

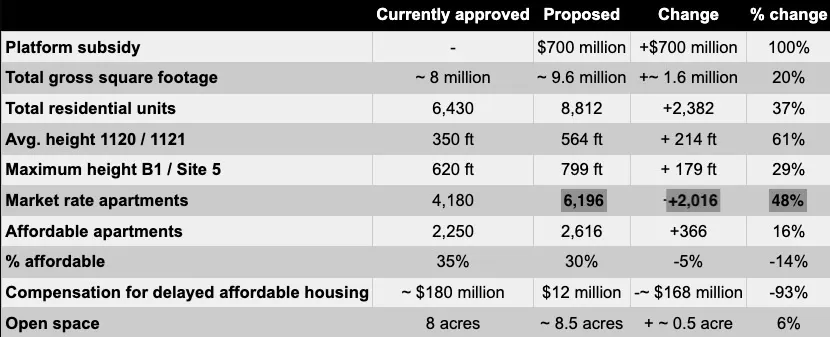

So the results are slow progress for a borough-changing megaproject announced in 2003, approved in 2006, and re-approved in 2009, with the purported benefits--building over a "blighted" railyard, income-targeted "affordable" housing, new jobs and tax revenues, open space, removal of "blight"--long estimated to arrive within a ten-year buildout.

Graphic by Ben Keel and Norman Oder. Click to enlarge.

Instead, New York State, which has formal control of the project, in 2010 allowed a 25-year deadline, until 2035. Empire State Development (ESD), the state authority that oversees/shepherds the project, also allowed a more generous definition of "affordable" than what was promised.

See my Nov. 4, 2024 article for Common Edge, Delays Undermine Promises of Affordable Housing in Brooklyn, and the new infographic below, thanks to Ben Keel. For backing data, go here.


Meanwhile, the developers have taken advantage of direct public assistance, tax breaks, an override of zoning, the state's use of eminent domain, and a wired public process that bows to their interests, providing crucial slack when economic and political cycles make development tougher.

Atlantic Yards/Pacific Park, as indicated in the screenshot above right from The Real Deal, "has become a saga unmatched in the annals of New York development."

Momentum has come in spurts. By mid-2023, 3,212 apartments, of an approved 6,430 units, were finished, with 30% of the units in the four most recent towers income-restricted, or "affordable"--but not that affordable, as described below.

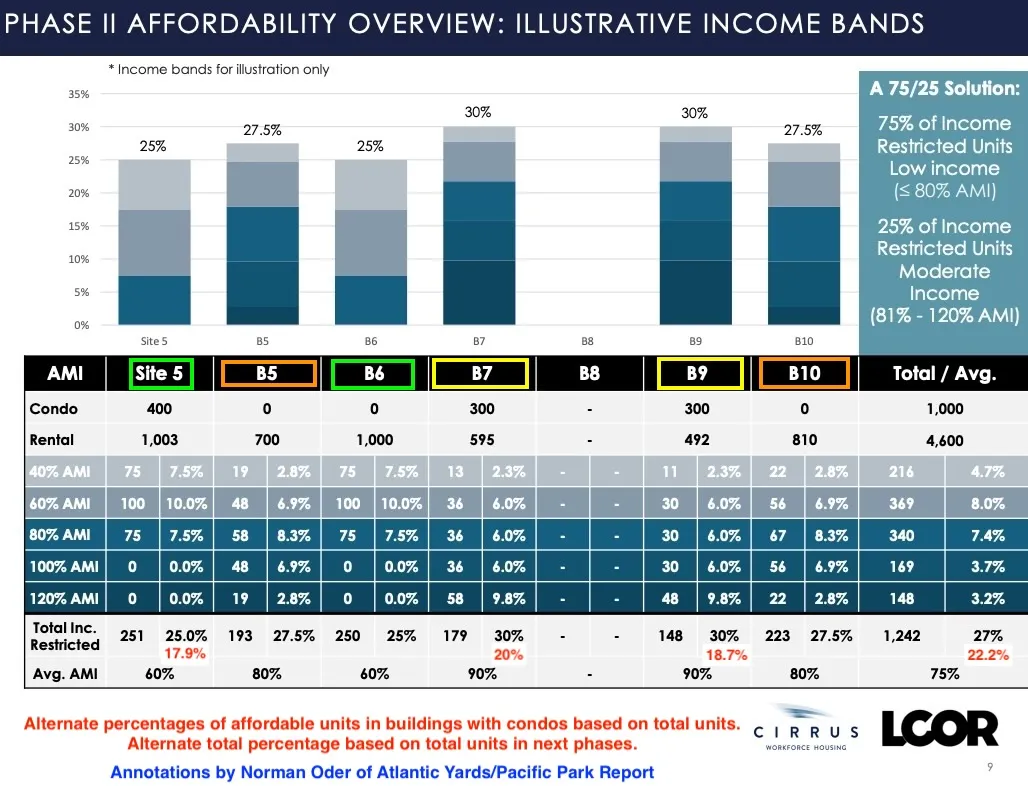

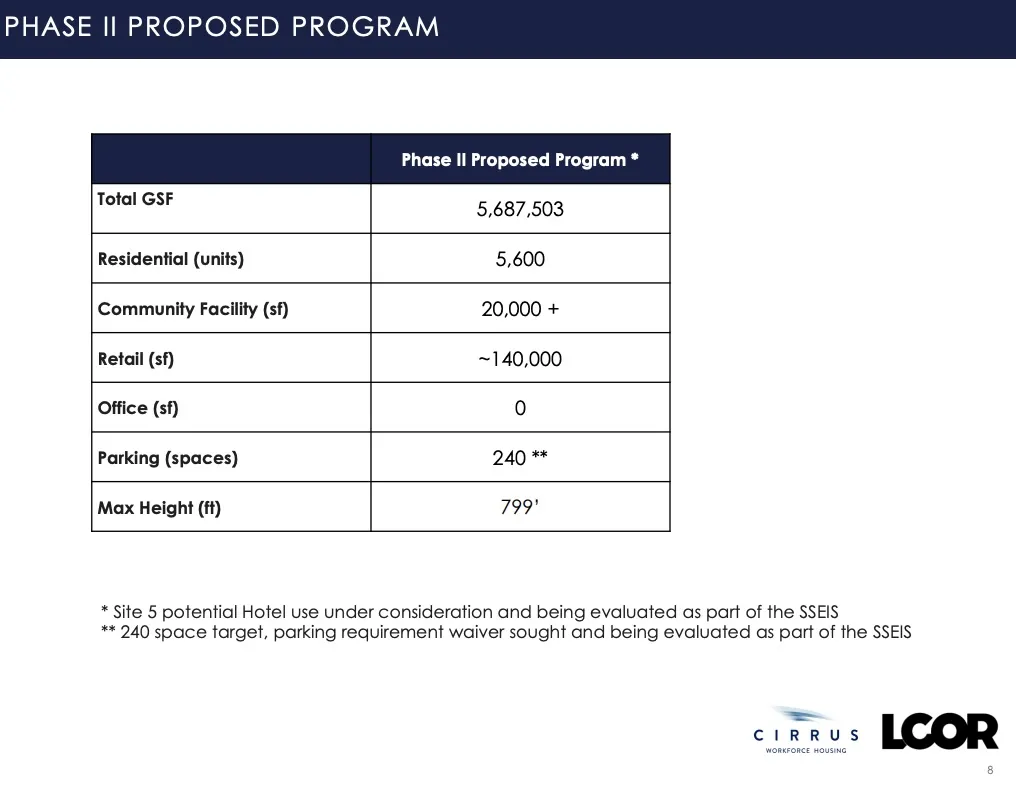

A much larger project might be built, if, for example, the plans proposed in 2023 come to fruition.

Graphic by Ben Keel & Norman Oder. Click to enlarge.

Disappointments, and lessons

So the jobs and affordable housing for struggling New Yorkers are way behind--and won't come close to fulfilling--the developer's projections and the supporters' hopes. Same for the other public support. That confirms my general critique that the project has, since its inception, been more enabled than overseen by state officials--what I call the Culture of Cheating.

One fundamental lesson: all scenarios should be offered in a range, from best-case to worst-case, because megaprojects have many moving parts, are subject to economic and political cycles, and likely won't turn out as promised. The public is owed candor.

Another lesson: promises should be locked in with penalties, pre-commitments of funds, "clawbacks," or opportunities for the public to reap some benefit from the project's winners. Ironically enough, original developer Forest City Ratner/Forest City Enterprises exited the project at a loss and the current master developer, Greenland USA, is also suffering.

The big winner, so far, have been the team owners, though not the first one. Russian oligarch Mikhail Prokhorov sold the Brooklyn Nets and the arena operating company--both scarce commodities, especially in the nation's media capital--for a huge profit, enabled by public assistance.

In June 2024, it was announced that Alibaba billionaire Joe Tsai, who bought out Prokhorov, sold a slice of the team and arena company for $900 million, to the Koch family, whose late patriarch was a notorious right-wing funder.

The Barclays Center, yes, has helped change Brooklyn. But it helped Prokhorov and Tsai above all and hasn't helped deliver what was promised.

Owners/Developers and Designers

A project proposed by a single developer, Forest City, and a single architect, the genius Frank Gehry, did not turn out that way.

Master developer Forest City was replaced by Greenland USA (which dominated Greenland Forest City Partners and is essentially solo until a successor emerges), finished buildings have been sold, and new developers for particular sites have entered. Meanwhile, Gehry didn't design anything other than a master plan, and several architects have worked on the project.

Graphic by Ben Keel and Norman Oder. Click to enlarge.

What's under construction? Nothing right now.

All towers, including the most recent ones, are on terra firma: B15 (662 Pacific St., aka Plank Road) opened in 2021 and B4 (18 Sixth Ave., aka Brooklyn Crossing) opened, in rolling fashion, in early 2022. The B12/B13 towers, now known as 595 Dean Street, began to open in April 2023.

But the open space on that southeast block--bounded by Dean and Pacific streets and Carlton and Vanderbilt avenues--wasn't finished until the fall of 2023. Several retail spaces in project buildings remain to be occupied, though there has been belated progress. The Chelsea Piers Fitness Center and Field House opened in June 2023.

However, 876 more affordable units must be delivered by May 31, 2025 to meet a state deadline, with significant penalties, at least if those penalties are upheld rather than renegotiated.

That deadline won't be met, especially since Greenland Forest City Partners pulled back from a plan, announced in May 2022, to begin a crucial platform.

Will a legislative "fix" be offered? Or, perhaps, will the developer gain an extension, and will ESD refrain from imposing penalties. Maybe that's an argument for rethinking the project.

At best, according to a Wall Street Journal source, construction could restart by late 2025, with a new developer.

What's next?

The future is unclear--and ever more so since the foreclosure sale surfaced in late November 2023.

Developer Greenland Forest City Partners as of Sept. 30, 2019 announced plans to build a platform for B5/B/6/B7 between Sixth and Carlton avenues starting in 2020. That didn't happen.

B5 through B7, with B4 at far left
A document I found suggested it would take three years to build the platform.

Similarly, permits were filed (and revised) in 2020 for B5, to be built along with the platform--but it didn't launch.

Both were projected to start in June or July 2022, but did not do so. Work on the platform for months has seemed imminent, but didn't launch, raising questions about the developer's commitment. Pre-planning was said to proceed for the adjacent B6 and B7.

Indeed, majority owner Greenland USA (part of Shanghai-based Greenland Holdings) has not previously met its projections. Now comes crunch time.

In 2022, advocates began focusing on another expected change in the project: an effort to shift bulk from the unbuilt B1 tower over the arena-plus-plaza (once dubbed "Miss Brooklyn") to move it to the unbuilt Site 5, at the far west end of the site, longtime home to Modell's and P.C. Richard. The latter still operates. A community garden is adjacent. (More on that below.)

Is the future of the railyard blocks and Site 5 intertwined? According to state officials at an August 2023 meeting that seemed to portray them as a package deal, yes. With the foreclosure sale, it's unclear.

We later learned, however, that Empire State Development in 2021 approved an interim lease for Site 5, which commits state official to supporting an even larger, two-tower project at Site 5.

Changing plans

The project has gone through many changes.

For example, the August 2014 tentative plans proposed by developer Greenland Forest City Partners have changed, but informed the August 2017 image below right, which assumed/presumed that there would be more buildings with condominiums and also more rental towers, as in the original plan, that were 50% affordable. (The image also omitted the "shadow" outline of the approved--but unlikely to be built--B1 tower, which is now added up top.)

August 2017 image, based on previous plans
The project is already well behind that tentative timetable and, by August 2018 there was evidence the full project would take until 2035, not 2025 as previously suggested in a now-stale timeline.

That further undermines one of the purported rationales for the project: the removal of the "blight" of an open railyard, which requires a deck for development.

General backstory & timeline

See my essay on the Culture of Cheating and the missing promised jobs. And my history of original developer Forest City Ratner, now Forest City New York

Here's an account of the project, as of 2018, since the 2011 Battle for Brooklyn documentary. As I wrote, it "may not be a 'Battle for Brooklyn' any more, but it is an unending saga, with the question marks--and taint--emerging in new ways."

See this extensive project timeline, divided among:
  • 2003-2006: Announcement, Debate/Protests, First Approval
  • 2007-2009: Recession, Lawsuits, Project Revisions, New Nets Owner
  • 2010-2012: Arena Launch, Timetable Questions, Arena Opening, Modular Gambit
  • 2013-2014: Delays Loom, Modular Stall, New Investor, New (Affordable) Timetable
  • 2015-2018: Initial Construction, Forest City Stall, Upheaval, and Exit, New Nets Owner
  • 2019-2024: New Developers Enter, Middle-Income Focus, Railyard Platform Delayed
Here's the official project web site, which does not look to have been updated since 2019. Here are two portal pages from Empire State Development, which oversees and shepherds the project. Below are some renderings of the project, and below that an FAQ.

The 2003 announcement

Here's an article, from my Learning from Atlantic Yards/Pacific Park newsletter, on the initial project plans: Flashback, Dec. 10, 2003: The Atlantic Yards Unveiling.

Screenshot from original project website

Here's an essay from my newsletter, A "Garden of Eden"? Revisiting a NY Times Rave for the 2003 Atlantic Yards Debut. The essay was quoted, misleadingly, in a mailer from the developer, excerpted below.

A June 2018 image of the full buildout

The image below is cropped from a Greenland USA press release. It omits the planned/proposed tower at Site 5, at the far west of the image.


A January 2018 graphic of the full buildout

The below graphic is more of a concept plan than a confirmed representation, from the firm L&L MAG (which in 2018 had a service contract with minority shareholder Forest City New York to represent the Greenland Forest City Partners joint venture, but apparently lost it as of 2019), but it does show the bulk from a different angle.

I've since annotated it with dates showing the opening of buildings. Note that the huge two-tower Site 5 project--the tall shaft at the west of the image--has been floated but has not been officially proposed, much less approved, though planning for governmental approval started. Also note that the towers over the railyard, of course, don't exist.


An image shared with the New York Post 9/30/19, of future towers over the railyard

At left is B4, flanking the Barclays Center. In the center are B5/B6/B7.

A massing model, east of Sixth Avenue

TF Cornerstone
The massing model below concerns the towers east of the arena block and Sixth Avenue (excluding B15, 662 Pacific) and was on the website of Thomas Balsley, the landscape architect who updated the master plan.

It needs an update, given that the designs for B12/B13, on the southeast block, were changed.

As shown in the image at right, the newest towers--rather than pairing with their opposite number (B12 with B11, B13 with B14)--instead are roughly the same shape, which allows for a more significant piece of open space between them, and a "gateway" on Dean Street.

It also might enhance the value of those rental apartments.

swaBalsley

FAQ (periodically updated)

How big is the site?

It's 22 acres, with public property--the Metropolitan Transportation Authority's Vanderbilt Yard--representing about 8.5 acres and public streets at least 3 acres. (In other words, it's not building "over a railyard.")

Originally 16 towers were planned (plus the arena); now there would likely be 15, though possibly one parcel (Site 5) would host a two-tower project. There should ultimately be 8 acres of open space, at least if the project is finished. As of late 2023, 3 acres were completed.

Atlantic Yards was announced in 2003. Why was the name changed to Pacific Park in 2014?

That was when Greenland USA, an arm of Greenland Holdings Group (Shanghai government-owned, in significant part) bought 70% of the project going forward, excluding the Forest City-built modular tower, B2 (461 Dean) and the arena operating company. I argued that it was an effort to distance the project from the taint associated with "Atlantic Yards."

Owners/Developers and Designers


So who owns the project?

See graphic above. The original developer was Forest City Ratner (later Forest City New York), an arm of Forest City Enterprises (later Forest City Realty Trust). Forest City was bought in late 2018 by Brookfield Asset Management, and its portfolio was absorbed.

Looking north from Flatbush & Sixth Aves., March 2021
Note the completed B2 & B3 & under-construction B4 & B15
The arena is nominally owned by New York State, to enable tax-exempt financing, but a privately owned company operates the arena and pays off construction financing.

Forest City in 2010 sold 45% of the arena operating company to Mikhail Prokhorov's Brooklyn Sports & Entertainment and in 2016 sold the rest to Prokhorov. (Prokhorov had bought 80% of the Nets in the first transaction, and the remaining portion in the second.)

Prokhorov in 2017 sold 49% of the Nets to billionaire Joe Tsai, and in 2019 sold the remainder of the Nets to Tsai, as well as the arena operating company. (I've argued that the sale of the Nets was not a record, as touted.) In 2024 came the Koch deal for 15% of holding company BSE Global, at an astonishing valuation of $6 billion.

The development sites are owned by New York State, but leased to the master developer, which can then sublease the sites; the new developer, after construction, can take ownership. The one tower built/operated solely by Forest City, 461 Dean (aka B2), was sold in 2018 to Principal Global Investors.

Forest City retained a 30% share of the three towers built before 2018 by the joint venture Greenland Forest City Partners: 535 Carlton, 38 Sixth, and 550 Vanderbilt. The joint venture, with Greenland owning 95% going forward, was to build the remaining towers.

However, since then Greenland Forest City has sold the rights to build on three development sites: B15 to The Brodsky Organization and B12 and B13 to TF Cornerstone. Greenland partnered with Brodsky on B4. Forest City had exited from B4 and Site 5.

Greenland had said it will develop B5/B6/B7 itself, but that won't happen, given the foreclosure.

In 2022, Greenland Forest City sold B3 and B14 to Avanath Capital, which oddly started by calling them Barclays I and Barclays II.

As of 2024, owners of the EB-5 debt, an investment fund formed to pool immigrant investors' money, are expected to develop the collateral--shares in a Greenland affiliate with the rights to developer parcels B5-B10--with a new investor via a foreclosure sale. That apparently would lead to the joint-venture involving Related.

How much will the project cost to build?

That's been a moving target As I wrote in 2016, the project price tag, initially $2.5 billion and long described as about $5 billion, had been described in a 9/16/14 press release issued by Greenland Holding Group, parent of Greenland USA, as involving a total investment of $6.6 billion. Surely the cost will go up. So maybe $8 billion is not unreasonable.

Where can documents regarding the project be found?

Try the Empire State Development's About Atlantic Yards page (now archived), notably the link to Additional Resources, which includes documents like the many-volumed Environmental Impact Statements and the original General Project Plan (GPP), a revision, and amendments.

ESD's main page is now Atlantic Yards Community Development Corporation, which offers a limited set of key resources.

I initially posted a variety of documents on Scribd and have since switched to Document Cloud.

Who do we contact with questions or concerns?

Pacific Park Brooklyn has a Community Liaison Office (CLO), once located on-site, now operating virtually. The CLO can be reached by phone at 866-923-5315 or by email, though real-time response--or any response--is hardly guaranteed. Some residents near site construction may be eligible to receive and have installed double-paned or storm windows and an in-window air conditioning unit.

Empire State Development, the state authority that oversees/shepherds the project, can be contacted here, and can put you on a mailing list for Construction Updates,  as well as last-minute updates, and other project-related information. Those Construction Updates were typically circulated every two weeks, but that's been suspended since late 2023, when no new work was foreseen.

About every two months ESD, along with the developer, typically holds/held a Quality of Life meeting--held virtually, since the pandemic--to update residents and hear concerns. That schedule began to lapse in late 2022, however.

The Atlantic Yards Community Development Corporation (AY CDC), formed after a 2014 settlement, is supposed to meet quarterly and advise ESD, but it's met infrequently and mostly been a rubber stamp.

What about the arena?

The Barclays Center sends out a monthly event schedule to neighbors. Contact Community Relations--see link here. It once had a 24-hour hotline for malfunctions of the blinking Oculus, but no longer.

What about the open space, aka "Pacific Park"?

The Pacific Park Conservancy oversees the project's open space. However, as I reported, it was something of a phantom. As of May 2024 its phone, 347-292-6479, and email, conservancy@pacificparkbrooklyn.nyc, were not functional. However, its phone number was since updated to 646-930-4852 and its email is supposed to be working.

What was the project's timeline, and how has it changed?

Here's a project timeline. Here's a visual history, up through 2010.

When Atlantic Yards was announced in December 2003 (here's the vastly overoptimistic original promotional material), it was supposed to take ten years to build. That same timeline persisted after the project received official state approvals in 2006. After delays, including lawsuits and the recession, project terms were changed in 2009.

A 2035 "outside date" was assigned for the project, with penalties for delay applied to only a few buildings and the platform. The affordable housing is due in 2025--but that deadline surely will face renegotiation. Representatives of the developer and the state, responding to queries in 2018 and 2019, refused to offer a timeline

But the developer, in a disclosure to condo buyers in 2018, acknowledged the project would take until 2035. ESD, in a 2022 document, acknowledged 2035 as well.

Here's another reason for expected delay: the developer doesn't need to finish paying for railyard development rights until June 2030.

The first tower was supposed to break ground in late 2010, but Forest City moved the goalposts at least eight times. It finally broke ground in December 2012, but took nearly four years to build.

How has the configuration changed?

The project was originally supposed to have 4,500 rental apartments in 11 towers, plus four office towers with space to house 10,000 jobs.

Later, one tower was added and much of the office space was swapped for condominiums, 1,930 in all, and space for far fewer jobs. However, despite approval of 1,930 condos, it's likely more rental apartments will be built, given tax breaks that cover the latter but not the former.

What happened in 2014?

In 2014, the state and community negotiators from the coalition BrooklynSpeaks, which had threatened a fair-housing lawsuit regarding delayed affordable housing, agreed to a settlement, with a May 31, 2025 deadline for the affordable housing, and to soon start building two "100% affordable" rental towers.

While many assumed--based on a tentative timetable/map dated Aug. 13, 2014 (below)--that 2025 represented the likely finish date for the entire project, that's long been untenable, both in schedule and configuration. For example, the loss of a tax break for condo buildings makes them unlikely.


Greenland had claimed it will meet the affordability deadline, which implies front-loading affordable units, but that's now untenable.

An executive from Greenland USA in June 2022 casually suggested that the project could be finished in "eight or nine years," or by 2031. Now that's unlikely.

The affordable housing was originally supposed to appear in rental towers that were uniformly half market-rate units, half below-market ones: "50/50," or, more precisely, 50/30/20, with 20% low-income units, and 30% moderate- and middle-income ones.

However, the 2014 changes reframed the configuration of affordability, with a severe skewing to middle-income units. Instead of devoting 20% of the units in the two "100% affordable" towers to units in Band 5, the most expensive cohort, those buildings have 50% Band 5 units.

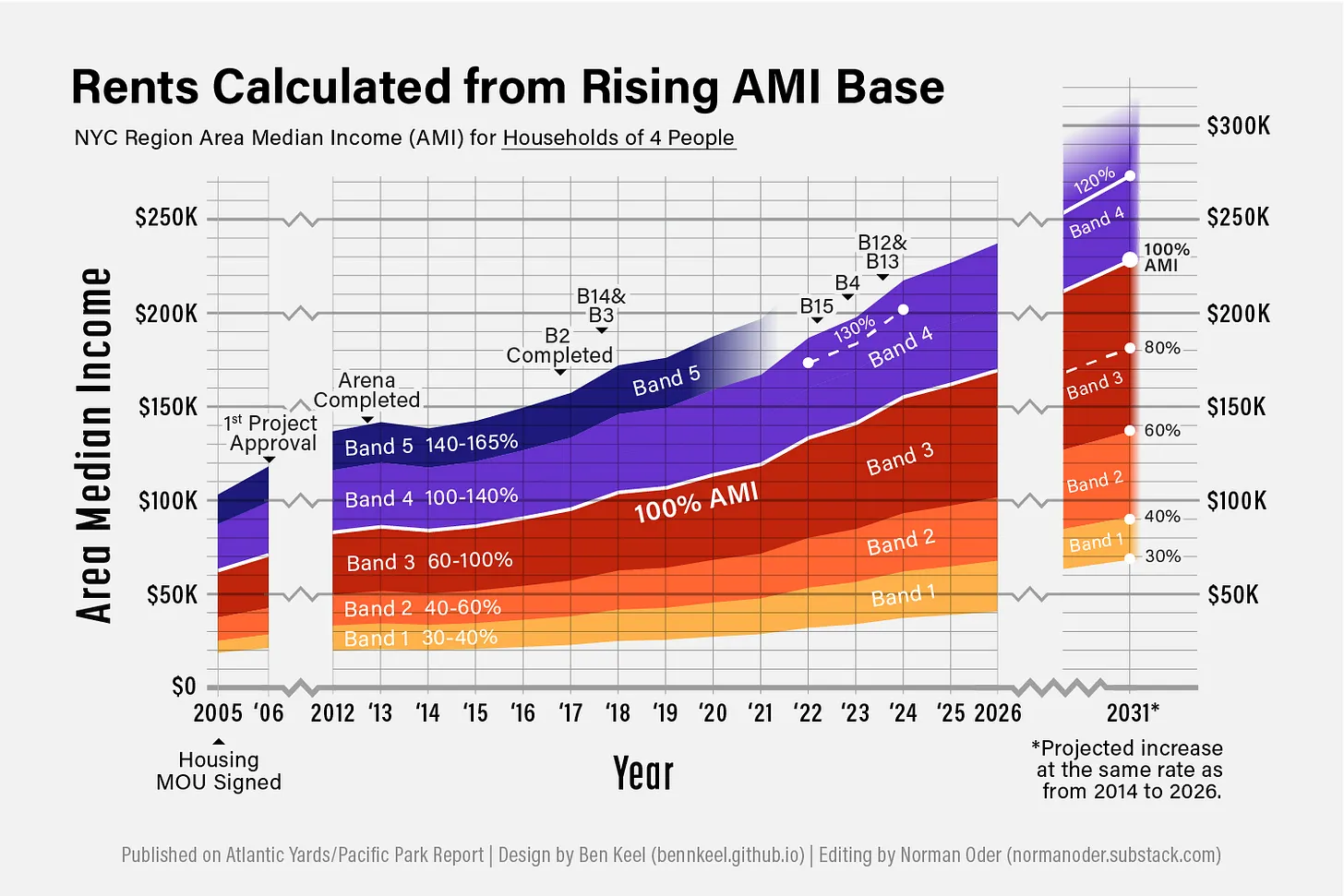

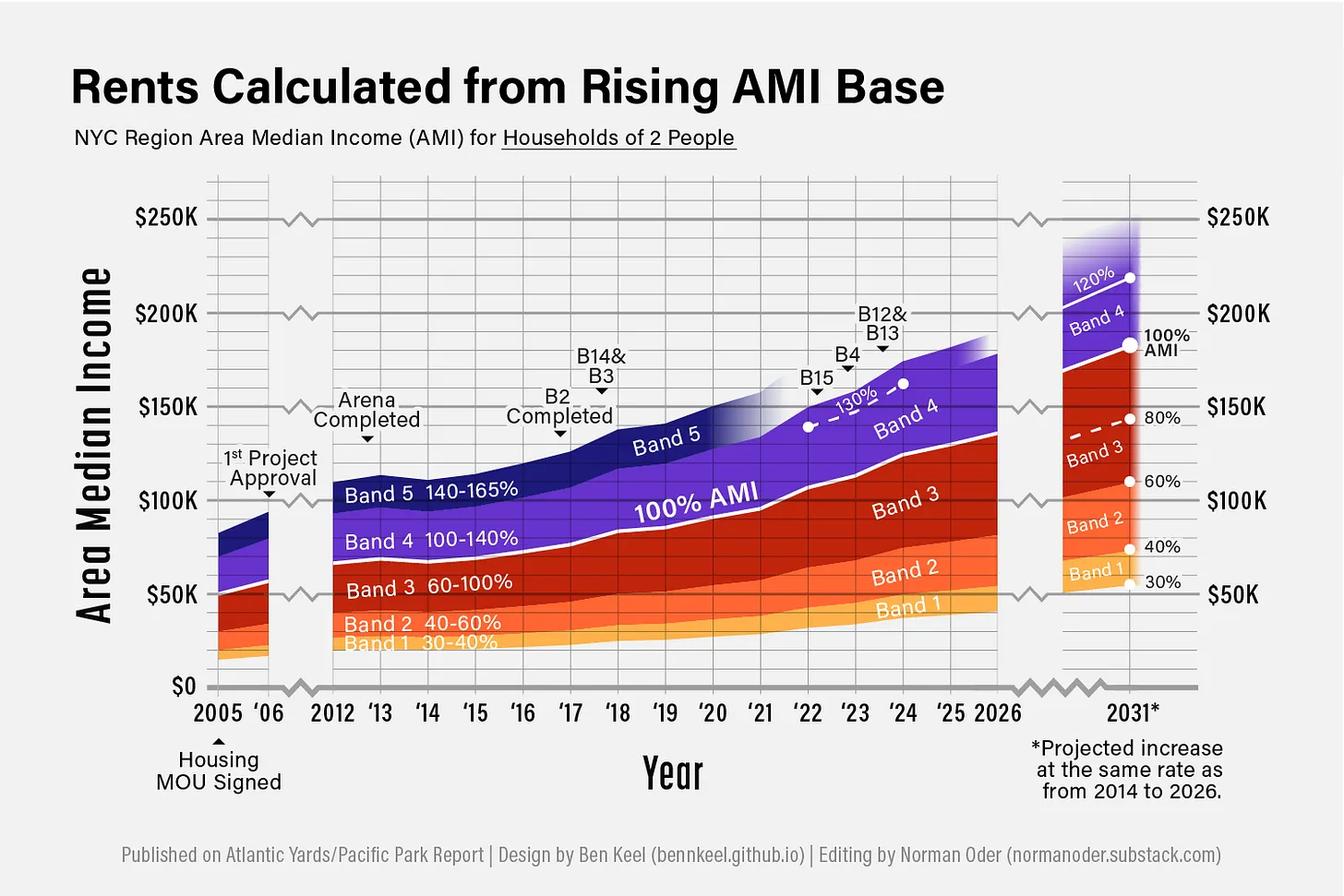

A graphic distributed in November 2020 indicates the overall skewing to middle-income households.

There was a stall, right?

Four towers were completed (or nearly so) when, in 2016, Forest City Realty Trust, at that point the junior partner in the joint venture with Greenland USA, announced it would pause new construction, citing rising construction costs and a glut of competing buildings nearby.

In early 2018, after Greenland agreed to buy most of Forest City's remaining share, the developer said it aimed to start a new building, B4, in 2019.

In October 2018, after Greenland said it had sold rights to three development sites, it projected that B15 would start in 2019, while B12 and B13 would start in 2019 or 2020.  (It was 2020.) All would be rentals, rather than containing condos in part or in full.

Will there be more condos?

The Affordable New York tax break--the replacement for the 421-a tax break--that expired in June 2022  only applied to rental units or condo buildings with 35 or fewer units. So previous plans for condos were in doubt.

That suggests more market-rate rentals will be built beyond the planned 2,250 such units. The belated 2024 replacement, 485-x, would not support condos at this project.

Wasn't the whole project--rather than just one tower--supposed to be built via innovative modular technology?

Yes. But it didn't work.

What buildings have been built most recently?

B4 (18 Sixth Ave., aka Brooklyn Crossing), on the northeast corner of the arena block, started in 2019, began to open early in 2022 and was completed in the fall. It's unclear how fast the 240 "affordable" units (of 858) were occupied.

B15 (662 Pacific St., aka Plank Road), once supposed to launch in December 2015, with a projected 2018 completion, was delayed by a dispute with neighbors and perhaps for business reasons. It contains space for what was once a planned middle school, which now will house both a high school and middle school.

While the building opened for residential occupancy in 2021, the school was been delayed, to an opening in September 2024 (faster than 2025); it is significantly larger than once estimated--806 vs. 640 seats and, instead of containing just a middle school, will also include a high school, plus a small special needs program. The original architect for B15 was retained.

The rental tower sites B12 and B13, on the southeast block, started in summer 2020, and began to open as of April 2023. That included one year to excavate the enormous space for a below-ground fitness center and fieldhouse. (B12, at that point a condo building, was unveiled in September 2015 as 615 Dean Street.)

How much does it cost to rent/own at Atlantic Yards/Pacific Park, in the market-rate units?

B2, 461 Dean Street: StreetEasy
B11, 550 Vanderbilt Ave.: StreetEasy (condos and rentals)
B15, 662 Pacific St.: Plank Road website; StreetEasy
B4, 18 Sixth Ave.,: Brooklyn Crossing websiteStreetEasy
B12/13, 595 Dean St.: 595 Dean website; StreetEasy

All are rentals, except 550 Vanderbilt.

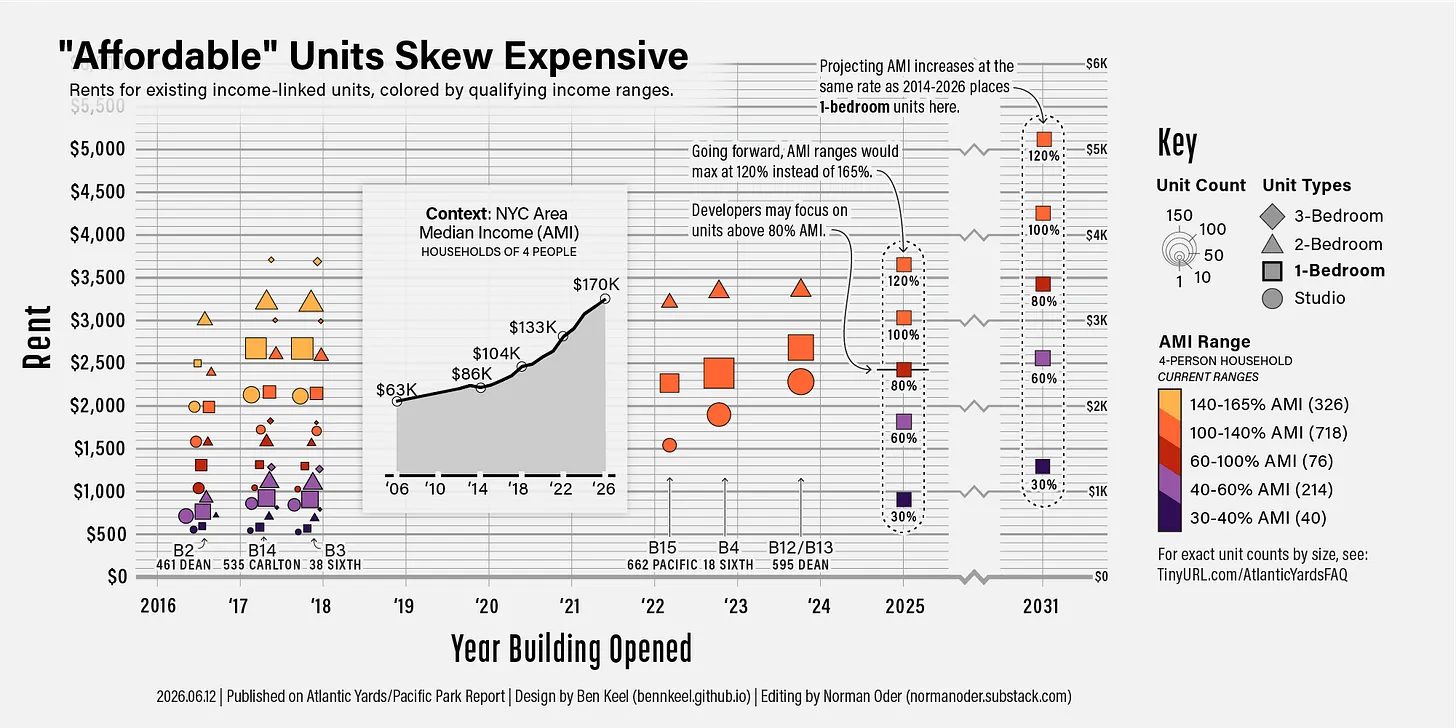

How much does it cost to rent at Atlantic Yards/Pacific Park, in the income-linked "affordable" units?

B2, 461 Dean Street: initial advertisement
B14, 535 Carlton Ave.: initial advertisement
B3, 38 Sixth Ave.: initial advertisement
B15, 662 Pacific St.: initial advertisement
B4, 18 Sixth Ave.: initial advertisement
B12/13, 595 Dean St.: initial advertisement

These are initial rents, which should have risen modestly, based on annual increases from the Rent Guidelines Board. See opening dates in top graphics.

How long does it take to build a tower (not over the railyard)?

At least two years, depending on size and complexity.

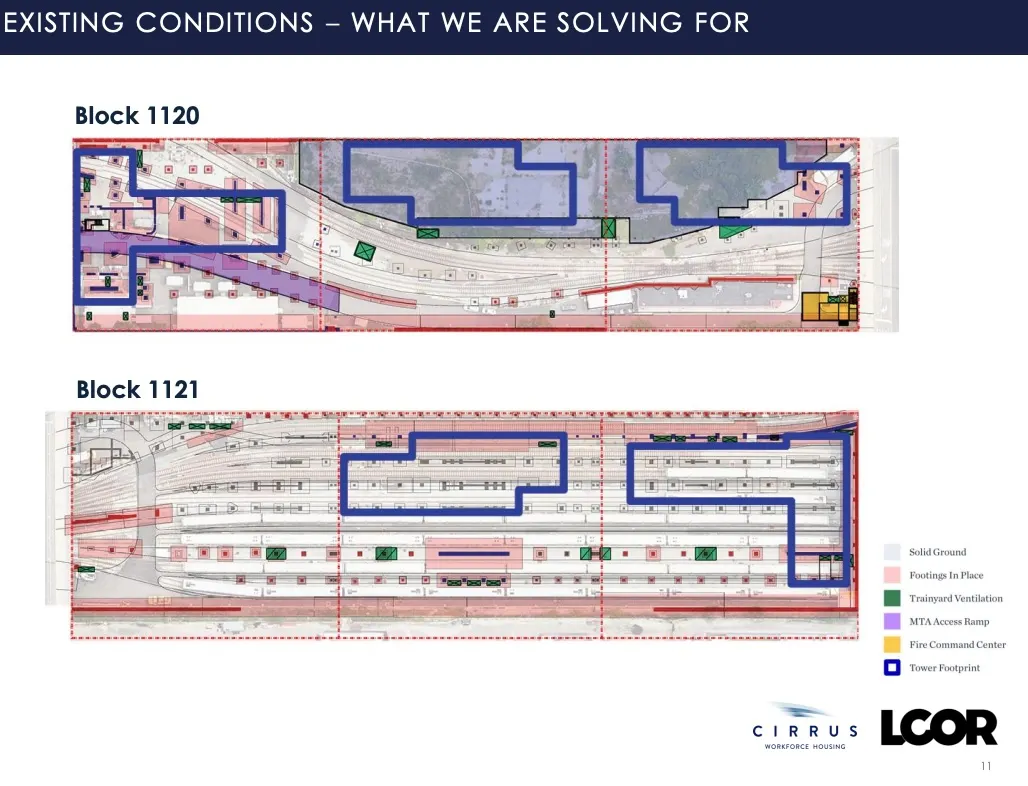

Block 1121 requires a platform for B8/B9/B10
What about building over the railyard?

That could take longer, since tower construction must be proceeded and/or accompanied by construction, perhaps in multiple phases, for each of three sections of the platform required for vertical construction over the railyard.

The overall elapsed time could take six years, or less, depending on how much has been done in preliminary work, and how much is done simultaneously.

The platform will be easier to build on Block 1120, home to B5/B6/B7, because likely more preliminary work will have been completed, and also because part of that block is already at grade (street level), thanks to the demolition of two buildings that "bumped" into the railyard. That allows cellars in those buildings, which have their "footprint" shifted toward Atlantic Avenue.

From 2019 coverage
How much would the platform cost?

As of 2019, it was estimated to cost $240+ million, including payments to the Long Island Rail Road. As of 2024, that likely would be more than $300 million.

Note that, as shown at the right, the cost of the first block--B5, B6, and B7--would be far less than the second block.

Could the last three buildings (B8/B9/B10) all be market-rate?

There might be a path to meet the affordable housing total--though surely not by 2025--without building over that block. So affordable units at those sites might not be required, though tax incentives (or subsidies) at the time might still stimulate some income-restricted units.

The market for such hybrid buildings, as well as the political backing for them, might be better than the market for all market-rate buildings. Or, by then, perhaps there will be a new real estate cycle and/or new public policies.

If those last three towers aren't built, well, the project will never get the major part of the promised open space.

Right. Nor would it deck the railyard and knit neighborhoods together, as long promised.

In back of 535 Carlton
Does the project have an "brand-new 8-acre park," as marketers have trumpeted?

No. The "park" won't be finished until the project is done. And it's not a park, but publicly-accessible, privately-managed open space

Until mid-2023, as shown in early 2018 photos, it was paltry, with space behind (and flanking) 535 Carlton and 550 Vanderbilt. Then the space on the southeast block was expanded to nearly 3 acres.

What is the open space supposed to include?

According to the 2006 Final Environmental Impact Statement, about 7.2 acres (90 percent) of the open space areas would be programmed for passive and flexible use, consisting of paths and lawns for strolling, sitting, people watching, and picnics. The rest, approximately 0.8 acres (10 percent), would be designated for active uses, including a half basketball court, a volleyball court, two bocce courts, and a children’s playground. That's not a lot.

The open space concept design, originally by Laurie Olin, was revised by Thomas Balsley and unveiled in July 2015. See below. It may not be finished until 2035, with key components reliant on the transition of Pacific Street between Carlton and Vanderbilt avenues--currently demapped to serve as a construction staging area--to green space.


Is the dog run a problem?

Well, for some neighbors in the West Tower of 595 Dean. That's why the Conservancy agreed to limit the hours in the evening, which didn't satisfy either dog owners nor plagued residents.

What about Site 5?

The developer wants--or, at least, wanted--to build a huge, two-tower project at Site 5, longtime home to P.C. Richard and also Modell's (now closed), catercorner to the Barclays Center. A large building has already been approved, but the developer wants to shift a significant amount of the bulk of the unbuilt B1 tower, creating a much larger structure.

2016 proposal

That would require a public process, including hearings and public comment, to change the project's guiding General Project Plan. As of late 2019, that process was supposed to get closer to launching; as of mid-2022, that process seemed to be approaching, as roadblocks have been removed. But it hasn't moved ahead.

In 2021, we later learned, Greenland proposed--and got state support for--and even larger version of the Site 5 project.


That would "preserve" the temporary arena plaza, a huge gift to the arena operator, since it serves as a place for crowds to gather, as well as a canvas for advertising and promotion.

Selling the parcel also could allow Greenland to reap some cash from its investment in the project, though if that happens without construction at the railyard, it would generate much criticism.

How many affordable units have been built?

As of now, 1,374. As of 2019, five towers (B2, B3, B4B14, B15) included 1,134 affordable units (of 2,412 total apartments constructed), including 254 (22.4%) highly-coveted low-income units, for which there was a huge response in the lottery. There are no income-targeted units in B11, the 550 Vanderbilt condo tower.

In 2023, two more towers, B12 and B13, known as 595 Dean, opened, adding 240 middle-income units.

The low-income units were originally pledged--in the Housing Memorandum of Understanding (MOU) and the Community Benefits Agreement, both nonbinding--to be 40% of the overall total of below-market units, so they're lagging.

Also, the Band 1 (up to 40% of AMI) units were supposed to represent one-fourth (25%) of the total low-income units, according to that MOU. Today the 40 units (of 254) are less than 16% of that total; there should be 63 or 64.

March 2019:  B14 has 298 units; the super's unit might count as affordable but
was not in the lottery. That said, Exhibit M counts only 297 units.

There's been a skew to middle-income units, as shown in the below graphic.


Is it hard to find tenants for middle-income units?

Yes, it has been. Some renters at 535 Carlton were offered two months free on a one-year lease, before the pandemic--and renters at both 535 Carlton and 38 Sixth were offered three-months free during the pandemic. (Rent at one market-rate studio actually dipped below an affordable unit within another project building.)

The housing lottery for 595 Dean was extended twice, for unstated reasons; I suspect that the rationale was to increase the pool of applicants, especially since the income ceiling had increased.

It's better to describe "affordable units" as "below-market" or "income-linked" or "income-restricted," since households are supposed to pay 30% of their income in rent.

What's next regarding affordability?

July 2020
The most recent buildings to open all have "affordable" units aimed at middle-income households: the income-linked units in B4 and those at B15 are for households at 130% of Area Median Income, or AMI.

The same was disclosed for B12/B13, despite the developer's caginess, and later confirmed by the lottery announcement.

The Affordable New York tax break--the replacement for 421-a that expired in June 2022--was skewed toward producing middle-income units: either the entirety of the total affordable units, or two-thirds, at least if--as in this case--the affordable units represent 30% of the total.

Of the 2,250 expected market-rate rentals, 182 were initially built, plus 218 in B15 and 600 in B4;  B12 and B13 added 286 and 272, respectively. That leaves 792 to be built, at least according to the official plans. But that's likely an undercount.

Of the 1,930 approved condos, 278 are built, and 1,652 remain to be built. That said, plans announced in 2014 indicated only 1,033 condos, which implied more market-rate rentals.

The new 485-x tax break should spur somewhat deeper affordability, but the overall impact, given rising income baselines to compute affordability, is unclear. In other words, a "low-income" unit will become ever more costly, because, say, 60% of Area Median Income will continue to increase.

Weren't half the affordable units, in terms of square footage, supposed to be geared toward families?

Yes, but Forest City backed off that pledge for two- and three-bedroom units with the first tower. 461 Dean. The next two rental towers, 535 Carlton and 38 Sixth, did have 35% of the apartments (in unit count) for families, which likely comes close to the square footage goals. But B15 (Plank Road) and B4 (Brooklyn Crossing) have no three-bedroom units.

How many people are expected?

Atlantic Yards/Pacific Park has a projected 6,430 apartments housing 2.1 persons per unit (according to Chapter 4 of the 2006 Final Environmental Impact Statement), which would mean 13,503 new residents.

That would mean 5,145 people in affordable units: 1,890 among in low-income rentals, and 2,835 in moderate- and middle-income rentals--but only if the original plan was followed, and it hasn't been. So there'd be more middle-income households.

That leaves 8,778 people in market-rate rentals and condos.

As of August 2023, the buildings finished include 3,212 units (1,374 income-targeted "affordable," if we count a super's unit, and 1,838 market-rate, which I believe includes units for supers) with the capacity for 6,741 people (using the 2.1 persons/unit estimate, which does not necessarily hold in each building, given different configurations of units; nor is every apartment necessarily occupied yet):
July 2006, pre-revision
How tall will the buildings be? What's the square footage?


See the two charts at right regarding maximum approved heights and square footages. The first is the original, the second is revised.

Click to enlarge. However, the totals would have to be modified if the Site 5 project is approved.

Also note a small shift in bulk--10,000 square feet--from B15 to B12, approved in August 2018. That probably won't be the only one.

What's the approved Floor Area Ratio (FAR), a common measure of bulk, indicating multiples of a full floor plate. (An FAR of 2, for example, can reflect two floors that fully cover the plot or, alternatively, four floors that cover half the plot.)


The Final Environmental Impact Statement stated:
The project’s overall density would be more concentrated on the western end of the project site (the arena block and Site 5), where the overall density would equate to a floor area ratio (FAR) of 8.6 (10.3 FAR not including the area of the streetbeds incorporated into the project site); the FAR on the project site east of 6th Avenue and would be 7.4 (8.2 without the streetbeds incorporated into the project site). The total FAR of the proposed project would be 7.8 (9.0 without the streetbeds incorporated into the project site).
December 2006, revised
Note that the lower calculation is a bit deceptive. The calculations producing the overall FAR of 7.8, the western end FAR of 8.6, and the eastern end FAR of 7.4 incorporate the demapped streets, while typically such calculation assume that buildings are next to streets.

To quote the BrooklynViews blog from January 2006, "In Brooklyn, the FAR measures density relative to the existing pattern of streets and blocks."

How much parking is expected?

The project approved in 2006 was to include 3,670 below-grade parking spaces. In 2014, the parking requirement was proposed for a cut, first to 2,896 spaces and then to 1,200 spaces. In 2019, the total was cut to 1,000 spaces, with these estimated uses: 300 for the arena, 24 for the New York Police Department, and 676 for residents.

However, the configuration shifted. See the graphic up top. The parking at Site 5 likely would be cut.

What's the impact of the coronavirus pandemic?

Well, it shuttered the Barclays Center in March 2020, and the #blacklivesmatter protests turned it into what I called an accidental town square. The arena reopened, without ticketed fans (though some guests), for Nets basketball in December 2020.

The arena reopened to larger crowds in early 2021 and fully vaccinated crowds later in the year, with a city rule barring unvaccinated players on home (but not visiting!) teams, including Brooklyn Nets star Kyrie Irving, who the team decided could not play only in road games--at least until they reversed themselves, controversially.

The arena, for the first time since opening, had to scramble to hire vaccinated part-time staff. Several concerts were postponed or canceled, so the arena schedule is still not yet back.

The pandemic has not, as far as we know, changed the design plans for any buildings, other than minor changes like automatic hand-washing stations in amenity spaces. Apparently the developers are assuming that, vaccines and new procedures will significantly restore previous assumptions.

After-hours work continued at several construction sites, impinging on neighbors working from home and/or having their kids attend "Zoom school."

How many jobs have there been?

That's tough to figure out, because, while there have been periodic reports of the number of workers at the construction site, or the number of total arena employees, the most important metric is FTE (full-time equivalent) jobs. Consider this analysis, which suggests that the supposed 2,000 arena jobs (since increased) can't add up to 1,135 FTE.

Arena jobs are part-time, not paying a livable wage. One hostess reported earning $13,000 a year; by another estimate, weekly pay was around $200. That said, wages have risen recently, along with inflation.

Suffice it to say that there's no proof of the supposed 15,000 construction jobs (in job-years), nor any evidence that the number of jobs, on a pro-rata basis, meets that metric. There are few permanent jobs, since only six residential buildings have opened, with building service jobs, plus limited retail. There are no office jobs, despite the initial promise of 10,000.

The developer failed to hire the promised Independent Compliance Monitor required by the Community Benefits Agreement. A highly-coveted pathway to union construction careers ended in a bitter lawsuit and murky settlement.

Besides that compliance monitor, what else is supposed to monitor the project?

The 2014 settlement that set up the new 2025 deadline for affordable housing also led to the creation of the Atlantic Yards Community Development Corporation (AY CDC), which is supposed to meet quarterly and advise on the project. (It has met more sporadically, and most members are there to listen and be led by Empire State Development staff, rather than to advise.)

The AY CDC is dominated by gubernatorial appointees, and has been mostly toothless, until recently. In August 2019, it delivered an anomalous deadlocked vote, unwilling to endorse (or oppose) new below-grade space for a fitness center and field house. That had no impact on the eventual approval, however.

In August 2023, it requested a report from parent ESD on the project's financial viability, but that has not been delivered. In January 2024, it requested a report from ESD on how developer Greenland USA spent the $349 million in EB-5 funding it received. The response was murky.

Where do elected officials stand on the project?

Times have changed since 2003-2009 last decade when City Council Member Letitia James (now Attorney General) and then-Borough President Marty Markowitz were on opposite poles, with fervent opposition countered by even more flagrant boosterism.

James was allied with Develop Don't Destroy Brooklyn, which is defunct. The current political configuration regards elected officials who are generally supportive, willing to sign a letter in favor of the project, and those who are somewhat critical, willing to sign a letter requesting information.

There's little political profit in being too out front in either direction, I suspect. Some of those officials have allied, loosely or not, with BrooklynSpeaks, the "mend-it-don't-end-it" coalition that continues, thanks to a few active individuals, as well as the cooperation of neighborhood and advocacy groups.

Here's my imperfect analysis:
  • Gov. Kathy Hochul: like all the governors, likely to help ease the project's forward path
  • Mayor Eric Adams was a steady supporter as Borough President, though his office has supported efforts to increase accountability; as Mayor, he's been "City of Yes"
  • (Former Mayor) Bill de Blasio: steady, not-so-informed supporter, given the importance of "affordable housing"
  • Sen. Chuck Schumer: longtime supporter, especially at the start
  • Rep. Dan Goldman: who knows (it never came up)
  • (Former Rep. Yvette Clarke: a steady supporter, if not particularly vocal)
  • Rep. Hakeem Jeffries: it's no longer in his district (he was the Assembly rep for the project), but he's been a mild supporter and occasional critic
  • Brooklyn Borough President Antonio Reynoso: position unclear; he's been somewhat critical but has shown up for arena photo ops
  • State Sen. Jabari Brisport, in 2021 replacing Velmanette Montgomery (a longtime ally of James's and project critic, but who didn't make the project a priority); he's been supportive of BrooklynSpeaks
  • Assemblymember Jo Anne Simon: a supporter of BrooklynSpeaks, she's been moderately critical
  • Assemblymember Robert Carroll; moderate critic, supportive of BrooklynSpeaks
Three new council members started in 2022: Crystal Hudson in the 35th, succeeding Laurie Cumbo; Shahana Hanif in the 39th, succeeding Brad Lander; and Lincoln Restler in the 33rd, succeeding Steve Levin. Only Hudson has said anything publicly about the project, and she's been moderately critical though, like Reynoso, not against arena photo ops.

Do people still support the project?

Sure. There's a huge need in the city for "affordable housing," and de Blasio made an example of this project, with relatively little public dissent or scrutiny, though the housing has hardly been as affordable as promised.

The most active (if any) signatory of the Community Benefits Agreement, the Downtown Brooklyn Neighborhood Alliance, distributes 50 free tickets (and, usually, tickets to one suite) to arena events to grateful nonprofit groups.

A lot of people have shrugged at the arena, which has not been as impactful as feared. But the afforda
But there's a general cloud over the project, thanks to the various challenges raised by project opponents and critics, as well as journalism, a documentary film, and a musical play.

Was Mayor Mike Bloomberg a party to the Community Benefits Agreement

No, he signed it as a witness.

Have some former project supporters or monitors changed their mind?

Investor Londell McMillan said "it breaks my heart to have been a party of the project." Fervent public testifier Umar Jordan said "they played Brooklyn." Former state overseer Arana Hankin said "there really is no accountability."

Did original developer Forest City Ratner make money on the project, given the benefits of public subsidies, tax breaks, and a zoning override?

No, it looks like they have taken significant losses. However, if they'd had the patience--tough with a public company--and skill set to run a basketball team, they might have endured to make a huge profit on the Brooklyn Nets, as Prokhorov and Tsai have done.

How much money did the developers raise via cheap loans from immigrant investors seeking green cards via the EB-5 program? How much did they save? Did the loans create jobs?

As I wrote regarding the third round of fundraising, $228 million and $249 million and $100 million, or $577 million. It's hard to specify the savings, but Fortune said "Raising $100 million through EB-5 can add $20 million to a project’s bottom line."

A leading industry middleman, who worked on the second and third rounds of Atlantic Yards/Pacific Park EB-5 fundraising, admitted that his projects typically don't need the money. That means EB-5 doesn't create jobs, which is the rationale behind the program.

Well, in this case they did need the money, because they haven't paid it back--thus leading to the pending foreclosure sale. Not that the money created jobs.

80 Flatbush initial proposal, near left. Arrow = Site 5
How has the area context changed?

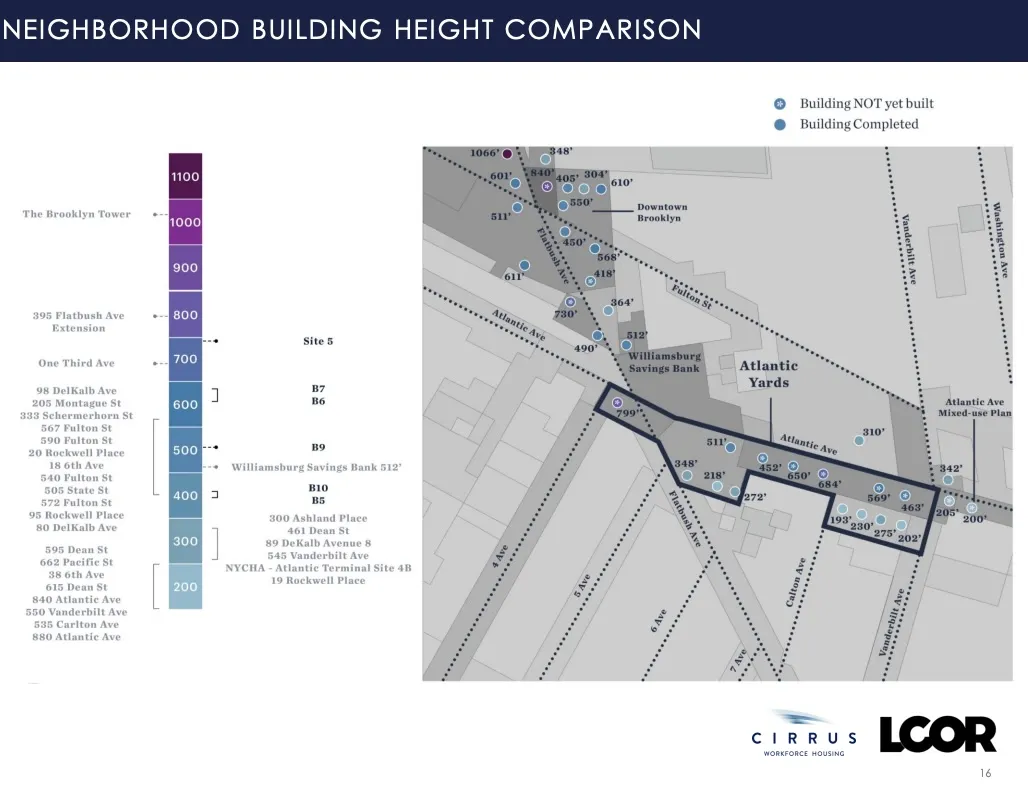

Until Atlantic Yards was announced, the 512-foot Williamsburgh Savings Bank tower, with a distinctive clock, was the tallest building in Brooklyn.

Original architect Frank Gehry's flagship Atlantic Yards tower, Miss Brooklyn, was supposed to be 620 feet. It was lowered to 511 feet in 2011, but would have been three times the bulk of the bank building.

Now it won't be built, as the arena's plaza will persist, but the bulk of Miss Brooklyn is expected to be transferred across Flatbush Avenue to Site 5, and a tower could reach 785 feet, at least according to 2016 projections.

The bank building has been sold: the upper floor offices are now condos, and the bank space became an event space and now retail. Meanwhile, the Downtown Brooklyn rezoning, and associated development around the Brooklyn Academy of Music, have changed the development spine along Flatbush Avenue, with numerous towers. A "supertall," The Brooklyn Tower, has risen more than 1000 feet, next to Junior's.

A 986-foot tower, part of 80 Flatbush, was proposed just north of the former bank building, now One Hanson, and was later approved at 840 feet. (The two-tower 80 Flatbush project was renamed The Alloy Block.)

The now-built 550 Clinton Avenue, with/near Pacific Park
So that to some degree normalizes the density/height around the arena block, at least that which solely borders avenues.

Site 5 would border row houses and low-rise apartments, in part, as do 38 Sixth and 662 Pacific, and the four towers on the southeast block of the site.

A new 312-foot tower just northeast of the Pacific Park site, 550 Clinton Avenue, shows the changing context, as well as awkward transition of the project to the south. It's known as the Axel.

Also, a proposed 18-story tower, 840 Atlantic, east across Vanderbilt Avenue from the B10 site has gained a spot rezoning, and is expected to rise on a parcel long occupied mainly by a drive-through McDonald's. The rezoning came after much negotiation and a reversal by Council Member Cumbo.

Two spot rezonings, for 17-story buildings to the east, were approved by Council Member Hudson, who also got the city's approval for a rezoning on blocks east of Vanderbilt Avenue: the Atlantic Avenue Mixed-Use Plan (AAMUP).

McDonald's site approved for 195';
buildings with blue/white stars are unbuilt;
those with blue/yellow stars are being built
Why did Forest City announce in 2018 that it would sell all but 5% of its remaining share to Greenland?

It cut its risks, and losses, as the firm, which had become a real estate investment trust (REIT), was aiming to avoid risky development projects and focus more on income-producing projects. We don't know the terms of the deal. By the end of 2018, Forest City was taken over by Brookfield Asset Management, so it's no longer an independent company.

Will Greenland make money?

Years ago, I wrote: too soon to tell. We don't know the terms of the second transaction with Forest City. We don't know the affordability levels and subsidies for future towers. We don't know what version of the Site 5 tower(s) will be approved, and how/whether they'll sell those development rights. We don't know future business/real estate cycles.

But Greenland also has/had other ambitions, such as making its mark in New York City and developing in an economy less volatile than China. And Greenland for the past few years has pulling back, both in New York and Los Angeles, selling pieces of its projects and lowering its risks.

Now the foreclosure suggests it's in bad financial shape. So it clearly has not made money, and the parent company is suffering.

Would the various subsidies, tax breaks, and government assistance have been approved if city and state officials knew they were benefiting a Russian oligarch billionaire and a company significantly owned by the government of Shanghai?

Good question!

What are some common mistakes in Atlantic Yards news coverage over the years?
  • Atlantic Yards is a project, not a place
  • It was not designed to be "over the railyards"
  • The project site is not in "Downtown Brooklyn"
  • Pacific Park is not a new neighborhood in itself (even a project architect called it an "extension to the existent neighborhood")
  • It was not a product of a "rezoning" and/or city approval
  • It was not the "same site" Walter O'Malley sought for a new Dodgers stadium (CJR coverage)
  • It would not provide $6 billion in new tax revenue
  • There were not 34 lawsuits
  • It's an arena, not a "stadium" (which is open-air)
Why was a green roof installed on the arena?

Well, the original plan was for public open space. Then it was for those in the four towers flanking the arena. Then it was eliminated, after the project was redesigned and reconfigured, with four towers no longer built simultaneously with the arena.

However, after a flaw in the arena design merely, as claimed, as some sort of public amenity. It was also aimed to tamp down noise escaping from the arena, and did so. So the arena's not that good a neighbor.

What's the total amount of subsidies, direct and indirect?

That's a tough one. But direct city and state subsidies total $305 million, or $285 million. (Forest City Ratner's seemingly generous payouts for property owners relied on $131 million in public funding from the city.)

New York State in 2006 said there'd be $292.9 million from mortgage recording and sales tax exemptions. That significantly undercounts public contributions, both in increased service costs and tax-exempt financing, as well as direct housing subsidies.

For the arena alone, the New York City Independent Budget Office in 2009 estimated a benefit to Forest City of $726 million in a combination of direct city and state subsidies, and city, state, and federal tax breaks. Given a smaller amount of tax-exempt bonds sold, I'd adjust that benefit downward by about $50 million.

However, city and state agencies backing the project said the IBO was wrong in not calculating the impact of the whole project (which the city agency said was impossible to do).

I'd add that the IBO left out the $200 million-plus value of the arena naming rights, which the state gave away. No one has counted the naming rights as a subsidy, though a state official once said that it was part of the financing for the arena. And no one's yet specified the overall value of housing subsidies.

Also omitted: the value of EB-5 financing, which is not a direct cost to the federal government but an opportunity cost (since the feds could get a better deal from marketing green cards).

How much direct aid did the city and state promise when the project was announced in December 2003?

None. The project, Bruce Ratner said, would be funded out of "incremental revenues." In a February 2005 Memorandum of Understanding, the city and state each promised $100 million. Only after the project was passed in 2006 did the city announced additional subsidies: apparently $105 million, as claimed by Forest City.

What other benefits are there?

A state override of zoning, which allowed the developer to build much bigger than allowed. (Remember, the project did not go through New York City's Uniform Land Use Review Procedure, or ULURP, because they city wanted a faster process.)

And the extension of a tax break to save buyers of condos at 550 Vanderbilt perhaps $50 million.

Also, the ability to use the arena site as a canvas for promotion.

What happened with the deal for development rights over the MTA's Vanderbilt Yard?

Here's the backstory regarding the key public property, 8.5 acres, part of the 22-acre site. The state's appraisal valued the development rights at $214.5 million, after the cost of a deck and a new railyard.

Instead of paying $100 million cash, a discount from the appraised value, Forest City got the authority--controlled by the mayor and governor--to agree to accept $20 million for the portion needed for the arena. The developer could pay the $80 million equivalent for the rest of the railyard over 21 years, at a gentle 6.5% interest rate. That's a savings of tens of millions in interest.

Beyond that, the agency agreed to accept a smaller replacement railyard. The developer got to save about $100 million. However, infrastructure costs have risen significantly.

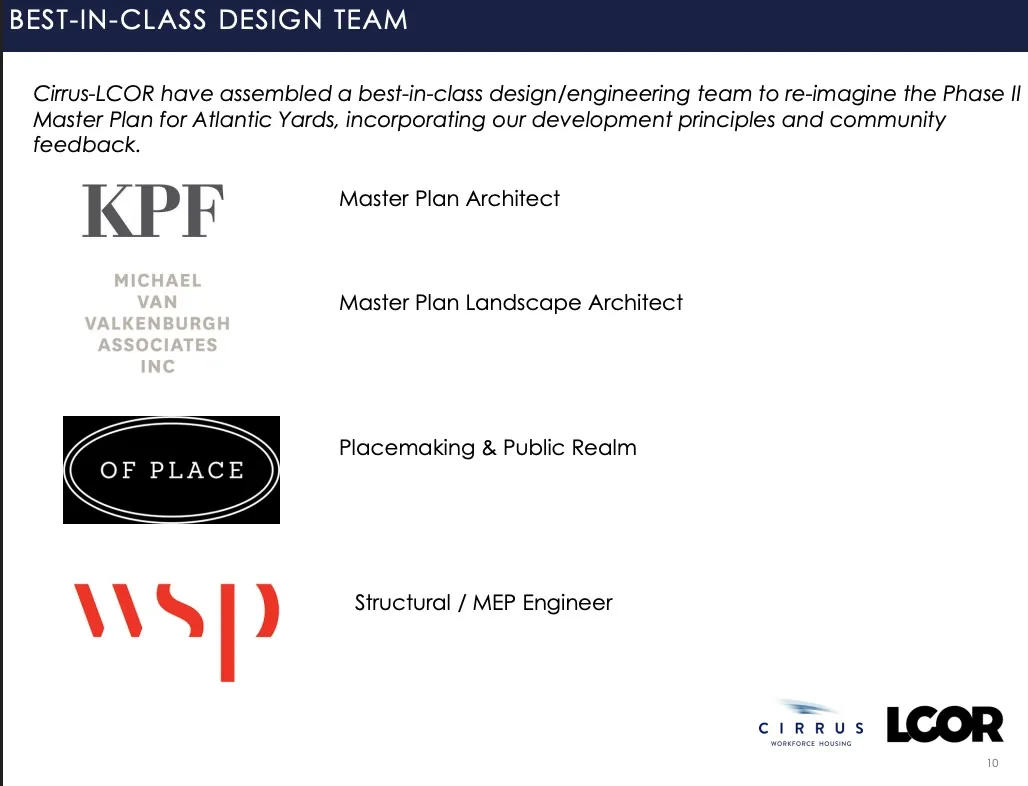

Who designed the project?

See graphic above. The original architect was Frank Gehry, who was supposed to design the entire project. However, his two-sport arena, big enough to accommodate basketball and hockey, was swapped for a cheaper, smaller arena focused on basketball, designed by Ellerbe Becket/AECOM.

SHoP was brought in to add the snazzy facade (and oculus), and to redesign the interiors, but the building's program didn't change.

SHoP has designed the arena plaza and three towers flanking the arena, the 461 Dean and 38 Sixth, and was initially supposed to design the unbuilt B4, which then became the work of Perkins Eastman.

CookFox has designed 535 Carlton and 550 Vanderbilt. KPF was announced as the designer of the unbuilt B12 (aka 615 Dean) and Marvel Architects as the designer of B15 (aka 664 Pacific), the building with the school. Marvel has stayed on. Handel Architects designed B12 and B13. Dattner Architects is working on B5.

Laurie Olin, or Olin Partnership, was the original landscape architect. The current landscape architect, for the concept design, is Thomas Balsley. But other firms, like Mathews Nielsen Landscape Architects, are working on specific buildings.

How many arena suites are there?

Well, the original arena was to have 170 suites, then 130, but the number came closer to 90. In March 2024, BSE Global announced a plan to swap 30 suites (of 87) for club-like spaces called The Row and The Key, accommodating a total of 436 seats.

How much were arena naming rights worth?

Not $400 million, as initially reported, but initially closer to $300 million, renegotiated to $200 million, over 20 years, or $10 million a year They were paid for by Barclays Capital, aiming to expand its presence. It has been reported, though not confirmed, that Barclays might want to exit the deal early.

How much are subway station naming rights (Atlantic Avenue-Barclays Center) worth?

$4 million, over 20 years. Paid for by the project developer, not Barclays. Of course an MTA official once stated that, given two stations in the complex, "it will be Atlantic/Barclays Arena and the Pacific Street/Barclays Arena." Then they were consolidated for clarity.

How much are uniform sponsorships, by Webull, worth?

A reported $30 million a year, though that was juiced by the Nets' temporary acquisition of superstars.

If that's the uniform naming rights, won't the arena naming rights be worth much more?

Seems likely.

Has the arena increased the amount of available exterior space to use for advertising and promotional signage?


How much does the arena pay in taxes?

Nada. Instead, payments in lieu of taxes (PILOTs) are used to pay off construction bonds, given the useful fiction of a nominally state-owned site.

Was the Atlantic Yards site truly blighted, a prerequisite for eminent domain?

I found that very very very dubious.

Do you lead walking tours of the Atlantic Yards/Pacific Park site, and environs? What about a class lecture over Zoom (or a similar platform)?

Sure, and tour guide is my other career.

I usually lead a free tour on the first Friday of May, as part of the annual Jane's Walk weekend, in honor of the urbanist Jane Jacobs, at least when there's no pandemic. I also offer tours for groups and classes, for a fee. And I can offer an online "virtual tour," or webinar/lecture.

Comments

  1. Great/helpful update (as always). What's the status of the school?

    ReplyDelete
    Replies
    1. See updates in FAQ for additional info.

      Delete

Post a Comment
